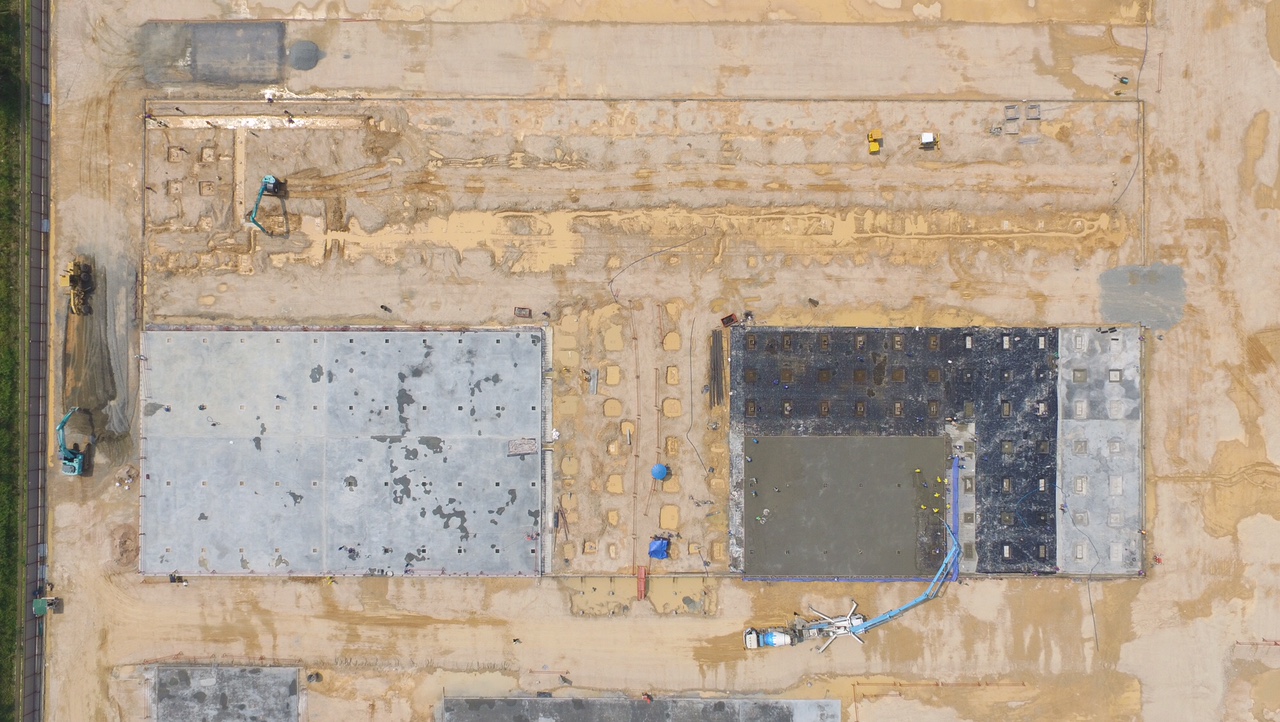

Construction is well underway and progressing smoothly. The construction team has completed the pad, trenching and now the concrete slab is being poured.
Almost 35% of the ground slab has been poured, and it will be 100% complete within the month.
The foundation is reinforced with a rigid mesh of steel rebar and is built over a substantial infrastructure of electrical and fiber optic conduit which has been fully installed and tested.
